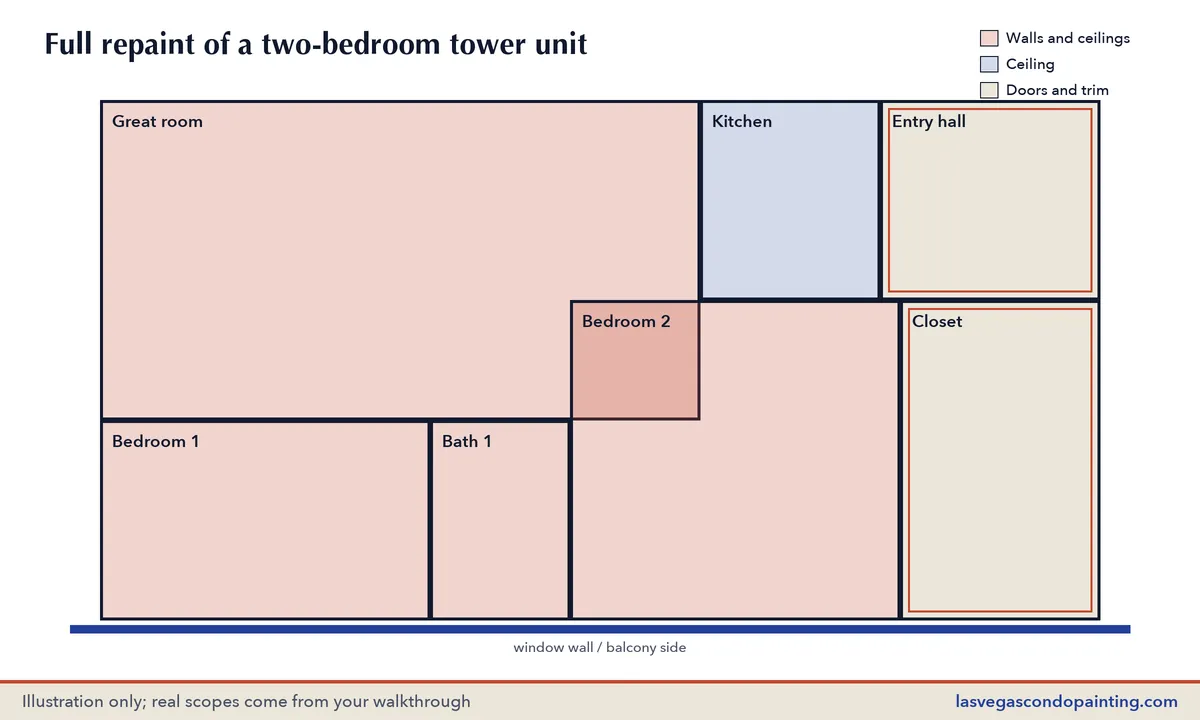

What a full tower repaint covers
Most owners ask for the whole interior at once: every wall, the ceilings, interior doors, door frames and baseboards. In a tower the list usually also includes the tall living-room wall that faces the glass, the soffits that hide the mechanical runs, and the closets nobody has touched since the building opened. If you only want part of the unit done, the full list of condo services shows the smaller scopes too.
Walls and ceilings in one visit
Ceilings are painted first so drips land on walls that have not been painted yet. Smooth and light-texture walls, common in tower units, show every patch under raking light, so repairs are sanded flat and spot-primed before the finish coats.
Doors, frames and baseboards
Trim gets a harder enamel than the walls because it takes the knocks from vacuums and luggage. Doors are painted in place or on stands inside the unit, never in a shared hallway.
Glass-wall light and sheen choice
Floor-to-ceiling windows throw low desert sun straight across the walls in the late afternoon. That light exposes roller marks and lap lines that a darker room would hide, so we favor a matte or eggshell finish on large walls and roll each wall in one continuous wet edge.

The building side of the job
Every residential tower has its own management office, front desk and set of contractor requirements. We do not guess at those rules or assume one building works like another. Before a start date is set, we ask your management office what it needs and then supply it. The questions owners ask most cover the common ones, and each tower district page notes how the buildings there differ in size and setting.
Certificates of insurance
Management offices commonly ask contractors for a certificate of insurance naming the association or building as certificate holder. Send us the wording your building uses and the certificate goes straight to the office, usually before you have to chase anyone.
Service elevator reservation
Ladders, drop cloths and paint go up in the service or freight elevator, not the guest cars. We book the window the building offers, pad the cab if the building asks, and keep loading to that window.
Work hours and front desk check-in
Crews arrive inside the hours your building allows, sign in at the desk or security office, and park where management directs. If valet or a loading zone is the only option, that is sorted out before the first morning.

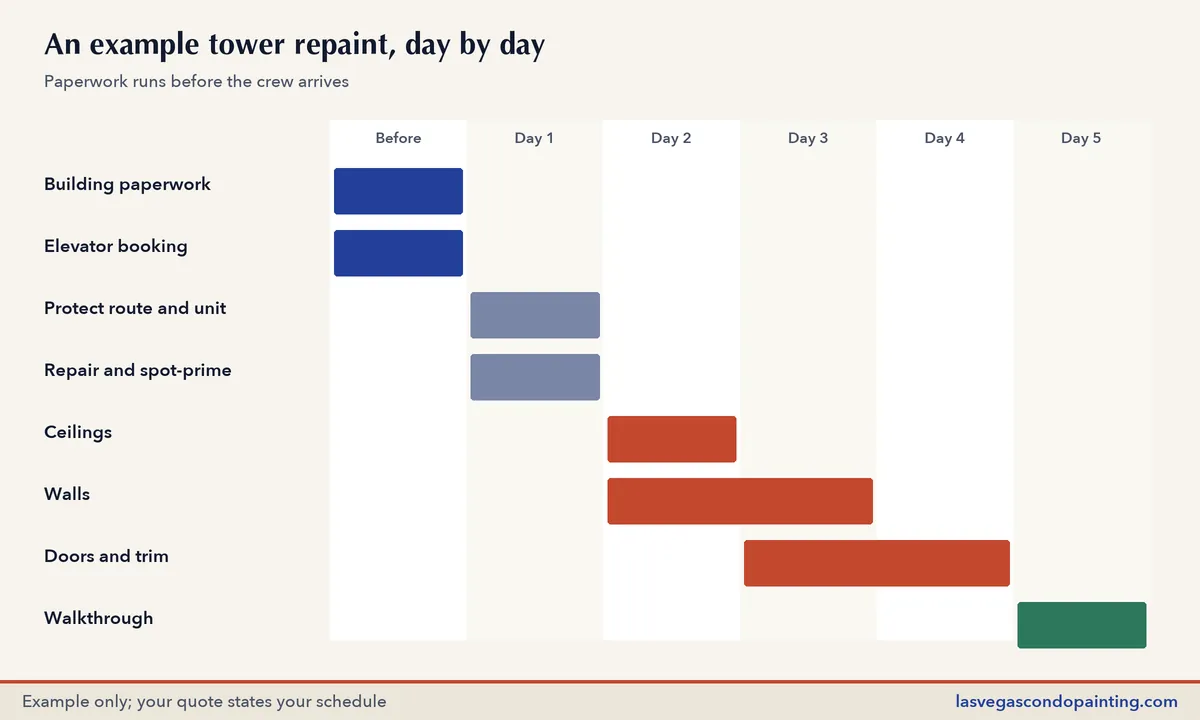

How it works, step by step
Photos or a walkthrough
Send photos and the unit size, or meet the estimator at the unit. You get a written, fixed quote.
Building requirements
We contact management for the insurance certificate wording, elevator rules and allowed hours.
Protect and prep
Floors, glass, fixtures and the route from the elevator are covered. Walls are patched and spot-primed.
Ceilings, walls, trim
Finish coats go on in that order, with sealed containers and clean-up each day.
Walkthrough and handback
You or your representative walk the unit, touch-ups are done, and the building is told the job is complete.
Ready when you are
Send the details now; the quote follows photos or a walkthrough.
Products for a sealed building
High-rise units rarely have windows that open wide, and air moves through shared systems. We use low-odor, low-VOC interior paints as the default and keep containers sealed between coats. If a neighbor has a sensitivity your management office has flagged, tell us during the quote and we will plan around it.
If the unit is about to go on the market, the pre-listing tower repaint page explains how we time the work against photos and showings.
Condo-hotel suites follow a slightly different path, set out on the condo-hotel unit page, and you can start any job from the estimate form.
Pricing a tower interior
There is no rate card on this site, because two units with the same square footage can price very differently. The main drivers are the ceiling height, the number of doors and the amount of trim, how much drywall repair the walls need, whether furniture stays in the unit, and how long the building's elevator window is each day. A walkthrough or a set of photos gives you a fixed written quote. Owners who will be out of state during the work should read about painting while you are away before booking.
Prefer to start with the building? Find it in the tower guide.

Questions about this service
Do I need to be in Las Vegas while my unit is painted?
No. Many tower owners are not. We arrange access with your front desk and send photo updates. The remote owner page explains how keys and authorizations usually work.
Can furniture stay in the unit?
Yes. Furniture is moved to the center of each room and covered. If a piece is too heavy or too valuable to move, tell us at the quote and we will paint around it.
Will you paint my balcony or the outside of the building?
Balconies, exterior walls and common corridors in a tower are normally maintained by the association. We paint inside your unit. Check your governing documents if you are unsure who is responsible.
